Your Project Priority List Got Challenged. How to Respond Like a PMO Leader.
Four steps to keep your project priority review from turning into a debate.
You’re twenty minutes into a portfolio review. The priority list is on the screen. You’ve walked through the top five, and everyone has been nodding along, until someone from the business side says, “I don’t understand why the customer portal redesign is ranked below the ERP migration. Our team has been waiting since Q1.”
The sponsor leans forward. Two other project managers go still because they can tell the agenda is about to get hijacked and their updates won’t get airtime.
Someone on the conference line unmutes, thinks better of it, and mutes again. You watch the conversation start to fork: one person is responding to the objection, another is opening a side thread about resourcing, and a third is checking their laptop like they’re already preparing for a priority list that looks different by end of day.
You’ve got about sixty seconds before this meeting belongs to the loudest voice in the room.
You’ve been here before. Maybe you tried to hold the line and it came across as dismissive. Maybe you opened the floor and spent forty minutes on a debate that ended with “Let’s take this offline,” which is corporate for “This will never get resolved.” Either way, you left the meeting knowing the priority list had less credibility than it did when the meeting started.
Objections are useful; they’re how new information enters the process. They only become a problem when they stay vague and everyone tries to resolve them in real time.
When the objection stays vague, the meeting ends without a next step.
Someone says “This doesn’t feel right” or “Our project should be higher,” and instead of treating it like an input to evaluate, the group treats it like a vote to count. The list gets reopened on the spot, and people start making their case. The energy in the room goes from “review” to “negotiation” in about twenty seconds.
The meeting ends without a decision, without an owner, and without a date. The priority list you walked in with is now in limbo. And you’re the one who has to explain to your leadership team why the portfolio order is different from what they approved last month, or worse, why it’s unclear if it changed at all.
The follow-up is even worse. You spend the next two days fielding messages from project managers who want to know if their project moved. The sponsor who raised the objection calls to ask what was decided. You check your notes and realize nothing was decided.

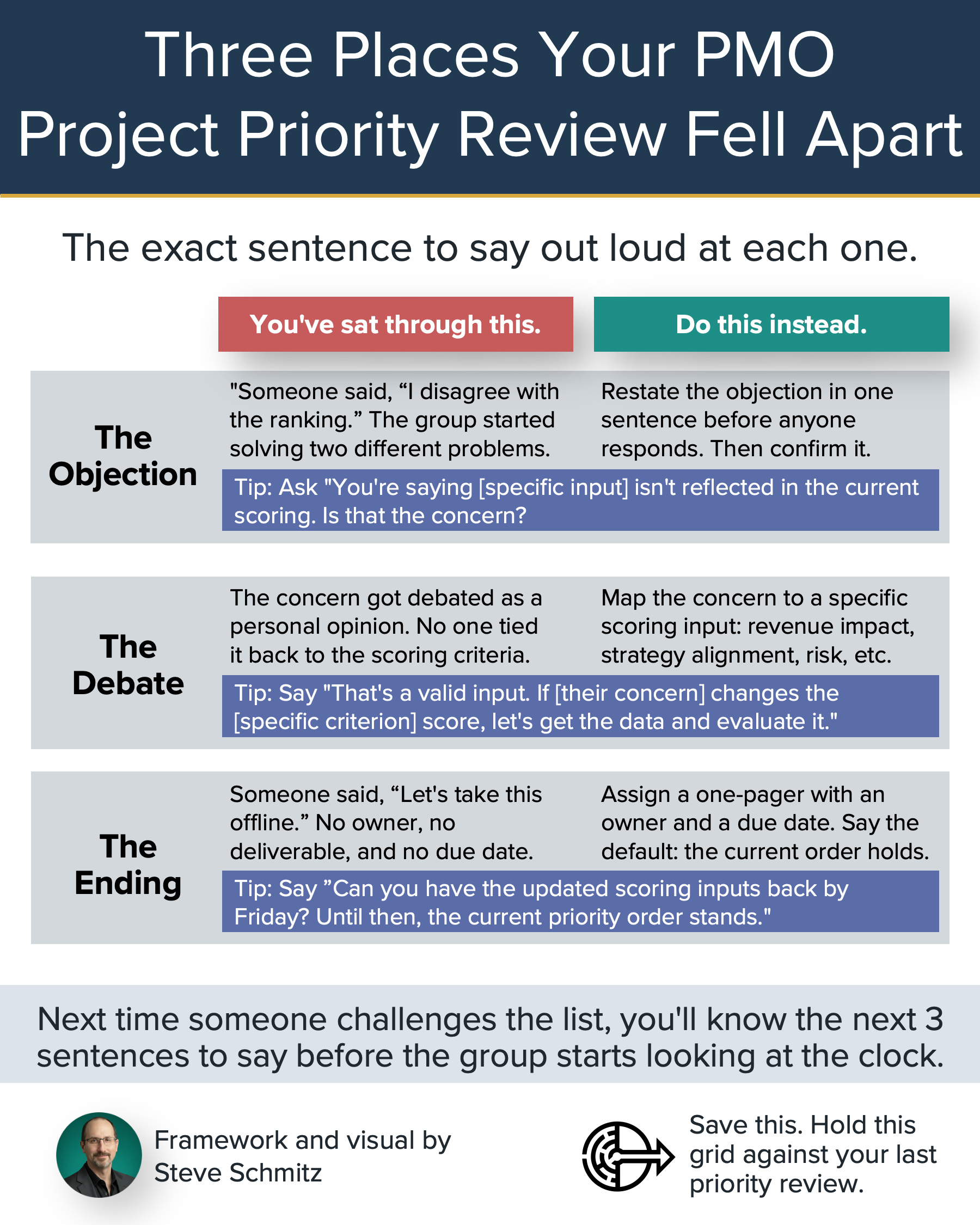

This is where most PMO leaders lose ground, but it doesn’t have to play out that way. There’s a 4-step pattern you can run in the meeting, in real time, that keeps the conversation productive and the priority list intact until there’s a reason to change it.

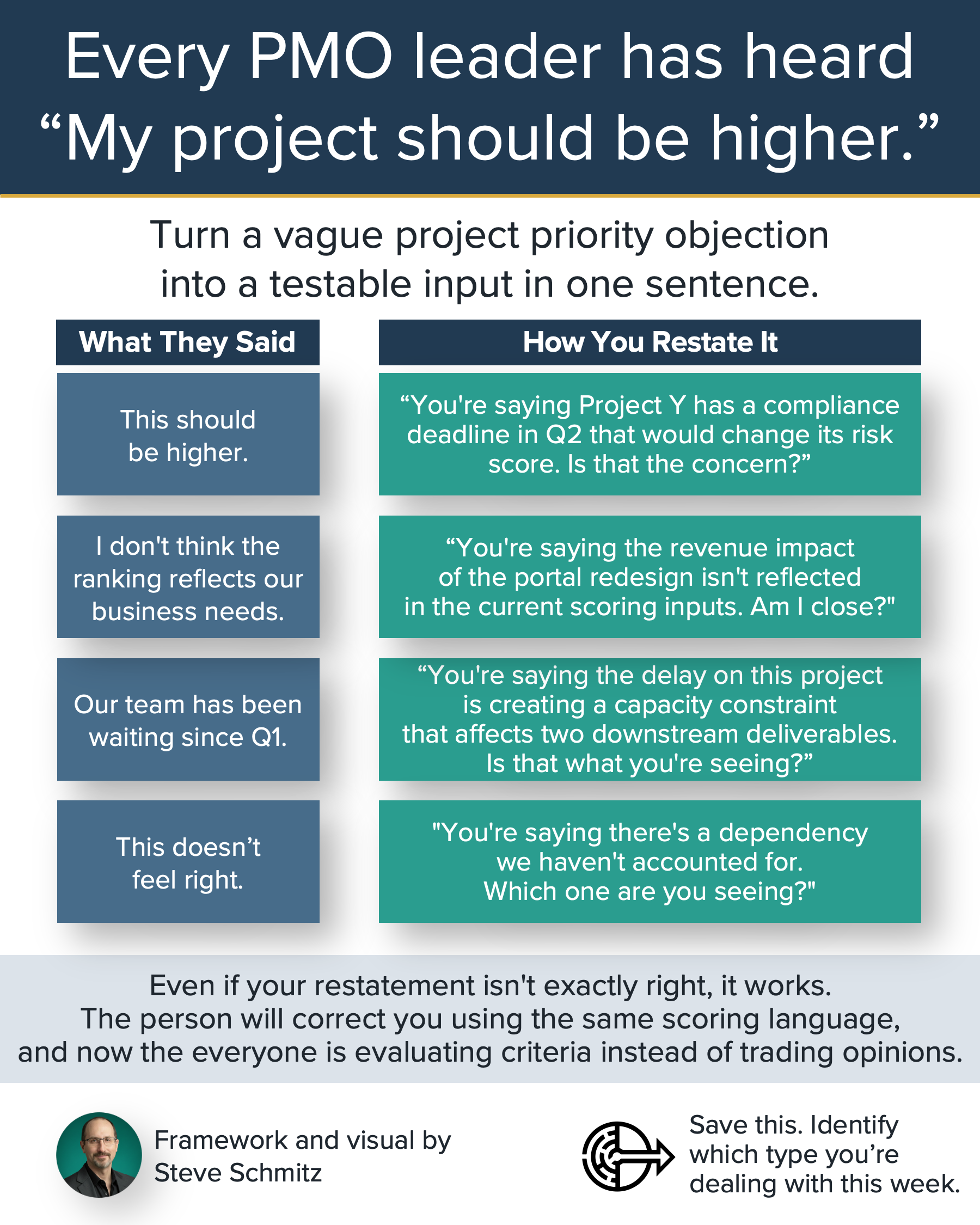

Step 1: Restate the objection in one sentence before the group starts solving two different problems
The first thing you do when someone pushes back is slow the room down. Take the objection, whatever form it arrived in, and compress it into a single sentence. Say it back to the group.
“You’re saying the customer portal redesign carries a Q2 revenue dependency that isn’t reflected in the current scoring. Is that the concern?”
You’re not agreeing, and you’re not disagreeing. You’re making sure everyone in the meeting is looking at the same issue before anyone starts solving it. Most objections arrive as broad statements or feelings like, “This should be higher” or “I don’t think the ranking reflects our business needs.” Your job is to turn that into something the group can evaluate.
When you skip this step, you pay for it. The group starts debating two different interpretations of the objection. Someone keeps circling back with “That’s not exactly what I meant.” Ten minutes disappear, and it feels like the group has made more confusion than progress.
Say the one sentence, and confirm it. Then you’ve got something to work with.
There’s a side benefit to this step that’s easy to miss. When you restate the objection clearly, everyone else relaxes. They were bracing for a debate. Instead, they heard a precise question, and now they’re listening differently, less like jurors picking sides, and more like colleagues evaluating an input. You changed the posture of the situation with one sentence.
Once the stakeholder agrees on what the concern is, the next question is whether it connects to anything in your prioritization scoring model.
Step 2: Validate the concern in portfolio terms, without agreeing to change the list.
Take the restated objection and translate it into the language your priority criteria already use: risk exposure, compliance deadlines, capacity constraints, revenue impact, strategic alignment. You’re converting “I feel like our project should be higher” into a specific input the scoring model can process.
“That’s a valid input. If there’s a Q2 revenue dependency we’re not accounting for, that could change the business impact score for this project.”
This does two things.
It shows the person who raised the concern that you took them seriously. You didn’t dismiss it or redirect.
And it reframes the conversation around the criteria the group already agreed to, which means you’re evaluating the concern on shared terms instead of competing opinions.
Here’s the part that trips people up: validating a concern and agreeing with its conclusion are two different things. You can acknowledge that a revenue dependency is worth examining without changing the priority list on the spot. You took the input, but you didn’t change the output. Those are separate steps, and keeping them separate is what gives you room to manage the process.
Their concern is validated and framed in portfolio language. Now comes the part most people skip: the question that asks the group what they’re willing to give up.
Step 3: Turn the objection into a tradeoff question, and let the portfolio math do the talking
This is the hardest step, and the one that changes the shape of the conversation. Take the validated concern and convert it into a question the group can answer: if this project moves up, what moves down? What else changes? What does the portfolio look like after the swap?
“If we move the customer portal redesign above the ERP migration, the ERP milestone slips to Q3 and we miss the vendor integration window. Is that the tradeoff we want to bring to the steering committee?”
Most people who challenge a priority list haven’t thought through the second-order effects. They’re advocating for one project, not proposing a new portfolio order. When you ask the tradeoff question out loud, you shift the conversation from lobbying to analysis.
This plays out one of two ways, and both of them work.
The concern is real, but the cost isn’t worth it
Sometimes the person who raised the objection hears the tradeoff and pulls back. They didn’t realize that moving their project up meant pushing the ERP migration past a vendor deadline with a penalty clause. The concern was real, but once they see what it costs the portfolio, they withdraw it themselves. You didn’t have to argue the point because the tradeoff did the work for you.
The tradeoff is real, and the room needs more information to decide
Other times, the tradeoff is legitimate and the group sees it. The Q2 revenue dependency on the customer portal is hard, and bumping the ERP migration to Q3 might be the right call. The group doesn’t have enough information to decide in this meeting, but now they’re looking at a specific question with specific consequences, not re-debating the entire list. That’s when you close the loop.
In both scenarios, you’re not the one making the case for or against the change. You’re putting the tradeoff on the table and letting the tradeoff do the math.
Either way, the conversation needs one more step before people start checking the time.
Step 4: Assign a one-pager with a due date, and hold the current order until it’s reviewed.
Close the loop before the meeting ends. Assign someone, usually the person who raised the objection or the relevant project sponsor, to bring back a one-pager that updates the scoring inputs and lays out the tradeoff. Give it a due date and state the default out loud so everyone hears it.
“Sarah, can you have the updated revenue inputs and the tradeoff impact back by Thursday? Until we review that, the current project priority order holds.”
That last sentence is the one that protects the PMO. You’ve given the objection a path forward. But you’ve also made clear that the priority list doesn’t change on a feeling in a meeting. The priority order holds until there’s written analysis that justifies a change. If the one-pager comes back and the tradeoff makes sense, you can update the priority through your standard process. If the one-pager doesn’t come back by Thursday, that tells you something too.
This is the part where your credibility compounds. You didn’t shut anyone down. You didn’t get pulled into a debate. You ran the process: restate, validate, tradeoff, assign, and the meeting ended with a next step, an owner, and a date instead of an open question and a vague plan to “revisit this offline.”
One note worth specifying: the one-pager isn’t a case for why someone’s project should be ranked higher. It’s an update to the priority scoring inputs: the revenue data, the compliance deadline, the capacity constraint, and a clear description of the tradeoff. What changes if we re-rank, and what does the portfolio lose. Keep the format tight: updated inputs, proposed change, tradeoff impact, recommendation. If you let it become a persuasion document, you’re back to lobbying with better formatting.
The third time you run this, the meeting starts running it for you.
The first time you run this pattern, the group might be surprised. They’re used to priority reviews that end with someone promising to “take it offline” or a sponsor escalating because they didn’t get the answer they wanted.
The second time, people start to understand the rules. The third and fourth time, the behavior in the meeting starts to change. Sponsors show up to the review with a one-pager already written. Someone frames their concern in portfolio terms without being asked. A stakeholder objects to the priority of their project, and before you can respond, another leader in the room asks the tradeoff question for you.
You’ll notice it in a small way first: someone starts their objection with “I think there’s a scoring input we’re missing” instead of “I don’t agree with the ranking.” That’s the change. They’ve internalized the criteria, and they’re working inside the process instead of trying to work around it.
That’s when you know the process has taken hold: when someone else runs it and you’re just watching it work.
